Prime Contract Help

Manage owner contracts, schedules of values, and billing.

Use this guide to create the owner contract, build its revenue SOV, prepare contract documents for approval and e-signature, download a PDF, and understand deletion and accounting-sync consequences.

Start here

Create and administer

Create a Prime Contract

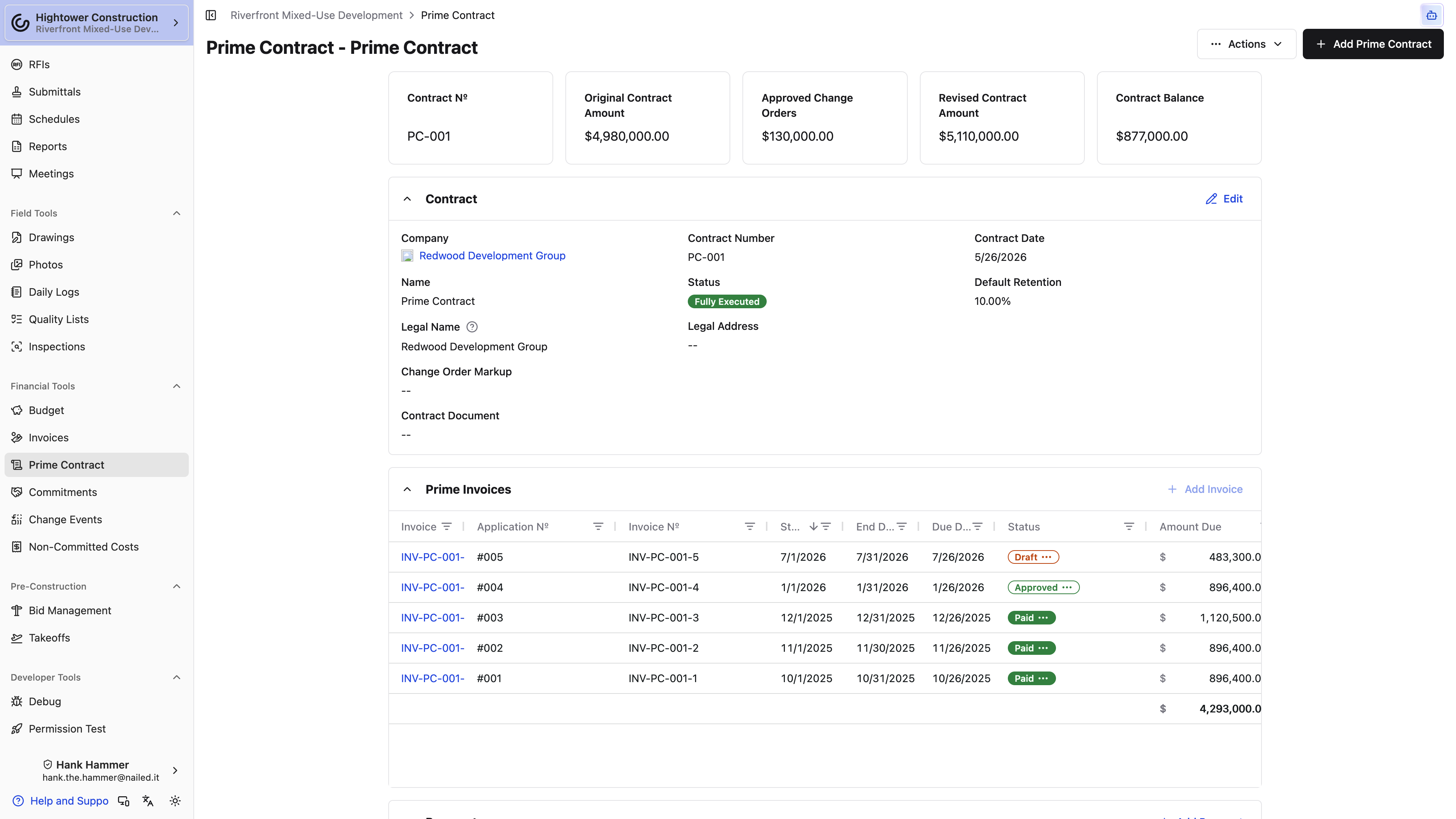

The Prime Contract shows contract totals, owner details, status, and Prime Invoices.
The Prime Contract shows contract totals, owner details, status, and Prime Invoices.
  1. Open Prime Contract.
  2. Select Add Prime Contract.
  3. Choose the owner company.
  4. Enter the contract number, title, dates, and other agreement details.
  5. Save, then build the Prime SOV.

The Prime Contract tracks owner revenue. Vendor and subcontractor costs belong on Commitments or Purchase Orders.

A project can have more than one Prime Contract. Use the Prime Contract switcher to select the agreement you intend to review, invoice, change, download, or delete.

Build and lock the Prime SOV

The Prime SOV is the line-item structure used by Owner invoices and Prime Change Orders. Add lines manually or import a CSV on desktop web. Confirm for each line:

  • Description
  • Revenue code, when enabled
  • Subproject, when used
  • Amount
  • Retention
  • Billing Type for progress billing or time-and-material billing

Revenue codes organize owner revenue. Cost codes and cost types organize vendor cost, so don't use the Prime SOV as if it were a subcontractor Commitment.

Lock the SOV after approval. Use Unlock the SOV for editing on a commitment only to correct the approved structure. A later owner scope change belongs on a Prime Change Order so its value and history remain separate.

Note: Once an SOV line has invoice activity, recoding it splits billing history. A line created by a Prime Change Order should be corrected through that change.

Set up Change Order markup

Most owner contracts let you add overhead, profit, insurance, or general conditions on top of the cost of a change. Set those percentages up once on the Prime Contract and every Prime Change Order can pull them in as line items, instead of someone working them out on a calculator.

Edit the Contract block on the Prime Contract and use Add Change Order Markup. Each markup needs a Name, a Percentage, and a Cost Code, plus a Cost Type when your organization requires one. Markups apply in the order they appear — drag them to reorder — which matters, because that order decides what each one is calculated on.

Calculation is the important field:

  • Basic takes the percentage of the change's own line items. Nothing that came before it counts.
  • Includes Above takes the percentage of the change plus every markup already applied. This is straightforward compounding.
  • Selective Compounding takes the percentage of the change plus only the earlier markups you tick under Include Prior Markups.

That third option exists because contracts are rarely tidy about this. A typical one lets you take profit on overhead but not on the insurance line — with Selective Compounding you tick the overhead markup under Include Prior Markups and leave insurance unticked, and the arithmetic follows the agreement rather than the other way around.

Worked through: on a $100,000 change with 10% overhead as Basic, a 5% insurance markup as Basic, and 5% profit as Selective Compounding including only overhead, you get $10,000 of overhead, $5,000 of insurance, and profit of 5% of $110,000 — $5,500 — rather than 5% of $115,000. Selective Compounding only appears on a markup that has something above it to compound.

To apply them, open a Draft Prime Change Order that has line items and select Add Markup Line Items. Each markup becomes its own line, described with its name and percentage, coded to the cost code you set. Once they're on, the button reads Markup Line Items Added — it won't add a second set.

Note: A markup with no cost code is skipped when the lines are generated. If a markup you configured doesn't show up on the change order, that's the first thing to check.

Set this up before the first change order goes out and the owner sees the same markup structure every time.

Prepare the contract for e-signature

  1. Finish the Draft contract and Prime SOV.
  2. Select ActionsPrepare for Esigning.
  3. Upload the contract document.
  4. Configure recipients, approvers, signers, and signature fields.
  5. Confirm and send.

When approvers are configured, they review in order while the contract is Awaiting Approval. It then moves to Out for Signing, Ready to Countersign, and Fully Executed as signatures are completed.

While an active e-signature flow controls the record, status can't be changed manually. Editing after execution requires Edit commitments and change orders after they have been executed and can require a separate accounting correction.

Understand approvals, status, and notifications

The contract document workflow notifies the configured approver or signer when their action is due. Its normal sequence is:

Draft → Awaiting Approval, when configured → Out for Signing → Ready to Countersign → Fully Executed

Void keeps a contract in project history without treating it as active. Use Void instead of deletion when the agreement should remain visible for audit or explanation.

Approvals and signatures apply to the contract document flow. They don't approve an Owner invoice or Prime Change Order; each has its own status and actions.

Connected owner workflows

Use the Prime Contract with invoices and changes

  • Owner invoices bill progress against Prime SOV lines. See How to use Invoices.
  • Prime Change Orders change owner revenue and can add lines to the Prime SOV when executed. See How to use Change Events.
  • A Prime Change Order's Billable On date controls when its value counts as billable and when its Budget Modification is created or updated.
  • Fully Executed records the document lifecycle. It is separate from Billable On.

Don't create a new Prime Contract for a monthly billing cycle or scope change. Use an Owner invoice or Prime Change Order against the existing agreement.

Use Prime Contract actions

From Actions:

  • Prepare for Esigning appears on a Draft without an active contract signing flow.
  • Download PDF compiles the current contract PDF.
  • Delete Prime Contract opens a destructive confirmation.

Deleting a Prime Contract removes its Owner invoices, SOV lines, Change Orders, attachments, and contract documents. The dialog lists the affected records before confirmation. This can't be undone in the app.

Correct an erroneous field or use Void when history should remain. Delete only when the entire record and every dependent owner-financial record should be removed.

Accounting and troubleshooting

Understand Prime Contract accounting sync

Sage Intacct can exchange Prime Contracts, SOV lines, Prime Change Orders, and owner invoices according to the organization's configured mappings. Some outbound flows create the accounting document but don't send later edits. Confirm the configured direction before changing an executed record.

QuickBooks owner billing is invoice-driven: an eligible Approved or Paid Owner invoice can become a QuickBooks Invoice, while a negative one can become a Credit Memo.

An integration icon or status describes the link to accounting. Fix and retry an existing failed link; don't recreate the Prime Contract or invoice.

Troubleshoot Prime Contract

Prime Contract is missing

Confirm the Financial package and View prime contracts. Also confirm the intended project and, when several Prime Contracts exist, select the correct record in the switcher.

Add Prime Contract is missing

The user needs Create new commitments, make changes to existing commitments.

An SOV line is read-only

Check whether the SOV is locked, the contract is executed, the line came from a Prime Change Order, or invoice activity exists. Correct the source record instead of rewriting established billing history.

Prepare for Esigning is missing

The contract must be Draft, the user needs financial write access, and no active contract signing flow can already exist.

Status can't be changed

An active e-signature flow controls status. Complete or resolve that flow rather than forcing the contract ahead manually.

Delete would remove owner billing history

Cancel the deletion. Correct the contract or use Void unless every listed dependent record should be removed.
